Utrecht uses more gas because of full power grid, other regions may follow

In a year there will be definitely extra gas generators in the province of Utrecht, to prevent overloading the power grid. According to network manager Stedin, it is “not a nice message” that it is necessary, but the generators will usually stand still.

The demand for electricity is growing faster in the Utrecht region than network operators Tennet and Stedin can keep up. If they do not intervene, large -scale power outages threaten on cold days, if there is a lot of demand and little supply of electricity. Last year it was already announced that gas is not shunned as a solution to this problem.

That is why Stedin held a so -called ‘flex tender’ for the first time. Such a tender is searched for suppliers who can supply flexible electricity. The FlexPowerNet and Rolls-Royce companies were jointly found out as the winner.

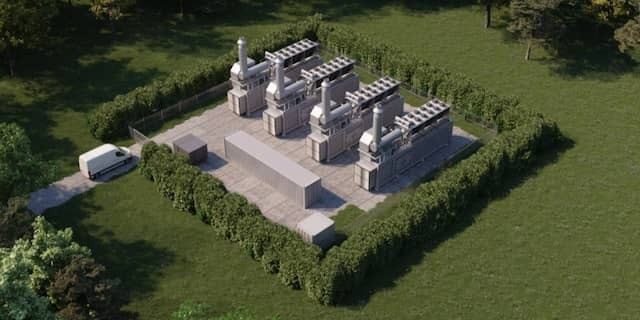

In the fall of 2026 they will place gas generators in six places in the province. There are four ship containers with generators per location. In total they can deliver 60 megawatts of electricity, enough for 60,000 households.

In practice they usually stand still, Stedin promises: only at peak times is used to gas. Around 2030, according to predictions of the network operator, it is about five hundred hours a year, just over 5 percent of the total.

To prevent noise pollution, the generators are placed at least 235 meters of homes. They also cannot be too close to Natura 2000 areas, because then nitrogen would descend on vulnerable nature. Stedin is still working on a search for suitable locations. Until now, only a place on the southern edge of the city of Utrecht is specifically in the picture.

Costs remain secret

Stedin and Tennet pay for the purchase of the generators and for every hour they are running. The network operators do not want to say what the costs are, which will ultimately be reflected in the account of all power users. “In the entire package of measures, this is by far the most expensive,” Warmold ten Zijthoff, regional director at Stedin.

That is why, according to him, the network operator prefers to look at other ways to relieve the power grid. To prevent the peak crowds on the net, cars will have to load at more favorable moments and companies will also be asked to avoid the rush. New buildings are being built in Utrecht in such a way that they use electricity smarter.

But despite the costs and CO2 emissions, the use of gas is justified, says Ten Zijthoff. “Because of this emergency measure, for example, we can connect 60,000 new heat pumps, which deliver sustainable heat throughout the year. I call it a little gray for more green.”

The expansion of the high -voltage network in Utrecht has been delayed for years, because a planned location for an electricity station turned out not to be suitable. As a result, it will probably take until 2033 or even 2035 before the problems on the power grid are definitively over and the gas generators can be removed.

Possibly other provinces will also have to use more gas later to temporarily tackle bottlenecks on the power grid, says Robert Kuik of TenneT. “We have to look at the need for it from region to region.”

If the expectations of the network operators show that the peaks on the power grid are short -lived elsewhere, this may also be collected with batteries. But because flexible power is needed in Utrecht for up to fifty hours, the network operators came out of gas as an emergency solution.
